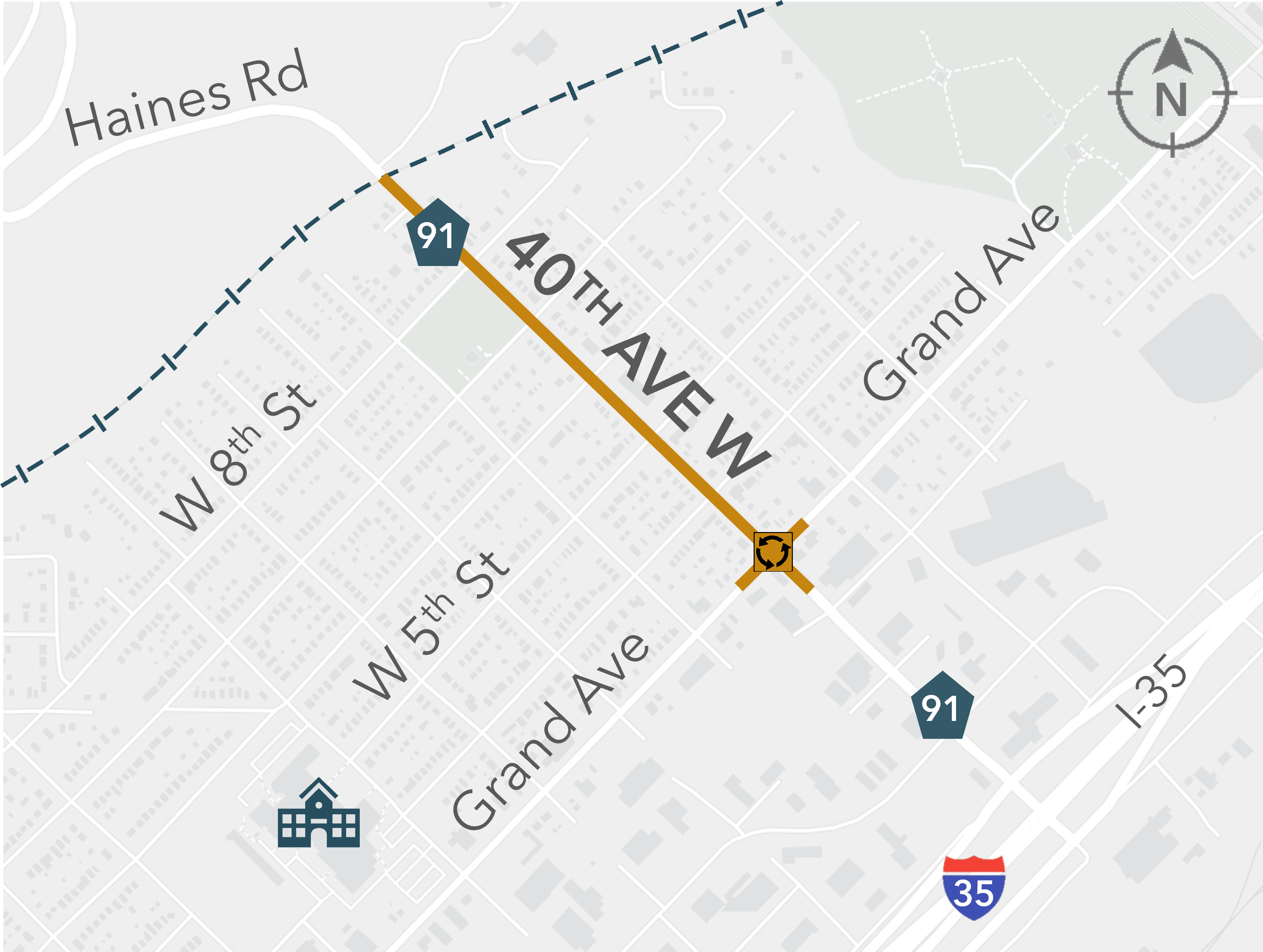

Overview
St. Louis County is leading a project in 2026-2027 to reconstruct 40th Ave West (CSAH 91) beginning at Grand Ave and ending near the railroad crossing (USDOT #251887W) for a total distance of approximately 0.42 mile. The project design is based on the preliminary layout that was developed from the 40th Ave West Corridor Study which started in September 2023 and completed in June 2024. This reconstruction project is necessary because the pavement section and curb and gutter on 40th Ave West are at the end of their service life. Likewise, the traffic signal system at the intersection of Grand Ave and 40th Ave West is nearing the end of its service life. The City of Duluth will replace city utilities along 40th Ave West in conjunction with the roadway reconstruction.
Key project components include:
Remove the traffic signal and construct a mini-roundabout at the intersection of Grand Ave and 40th Ave West.
Construct a raised center median along 40th Ave West beginning at Grand Ave and ending at 8th St. Openings in the median will be provided at intersections and alleys.
Construct a 10-ft path along the east side and a 6-ft sidewalk along the west side of 40th Ave West. Lighting will be provided for the 10-ft path and intersections.
Install an enhanced pedestrian crossing that utilizes a RRFB (pedestrian activated flasher) on 40th Ave West at 6th St.
The roadway reconstruction project in 2026 will stop approximately 100 ft short of the railroad crossing. A separate roadway reconstruction project for this gap is planned for 2027 in conjunction with a project to replace the signals and gates at the railroad crossing and extend the crossing surface. This separate roadway construction project will complete the connection of the 10-ft path on the east side of 40th Ave West to the existing sidewalk on the east side of Haines Rd.

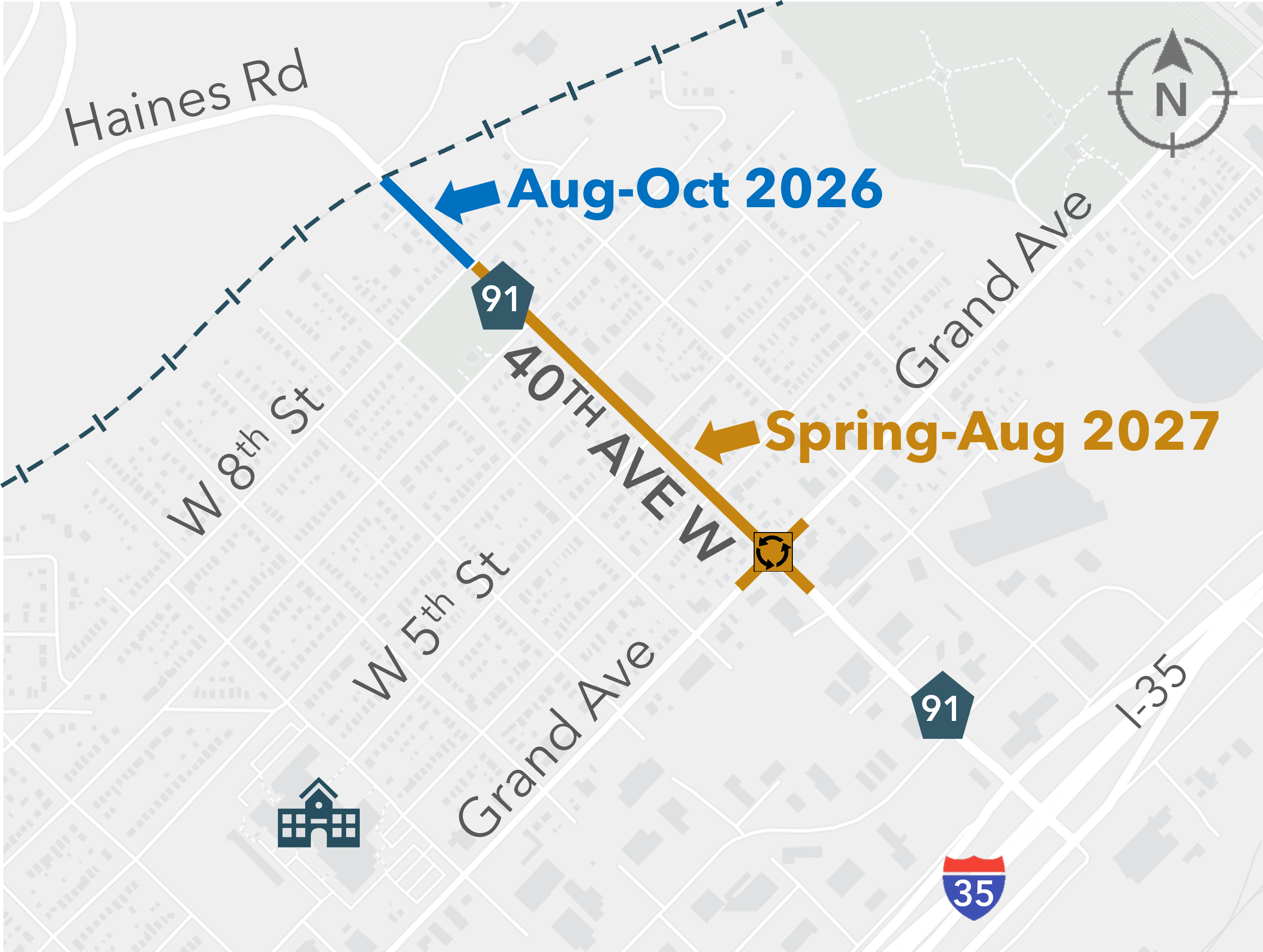

Construction Schedule
2026 Construction
Construction is expected to begin on August 10, 2026.
Work in 2026 will be limited to between 8th Street and the railroad tracks as well as some work outside the roadway at the Members Cooperative Credit Union.
This phase of work is expected to be substantially complete by October 31, 2026.
Temporary pavement and utility connections will be installed as needed to safely maintain the roadway over the winter.
2027 Construction
Major reconstruction will resume in spring 2027.
Construction will include the remaining roadway reconstruction and construction of the new mini roundabout at Grand Avenue.
The intersection of Grand Avenue and 40th Avenue West is anticipated to reopen to traffic by late August, 2027

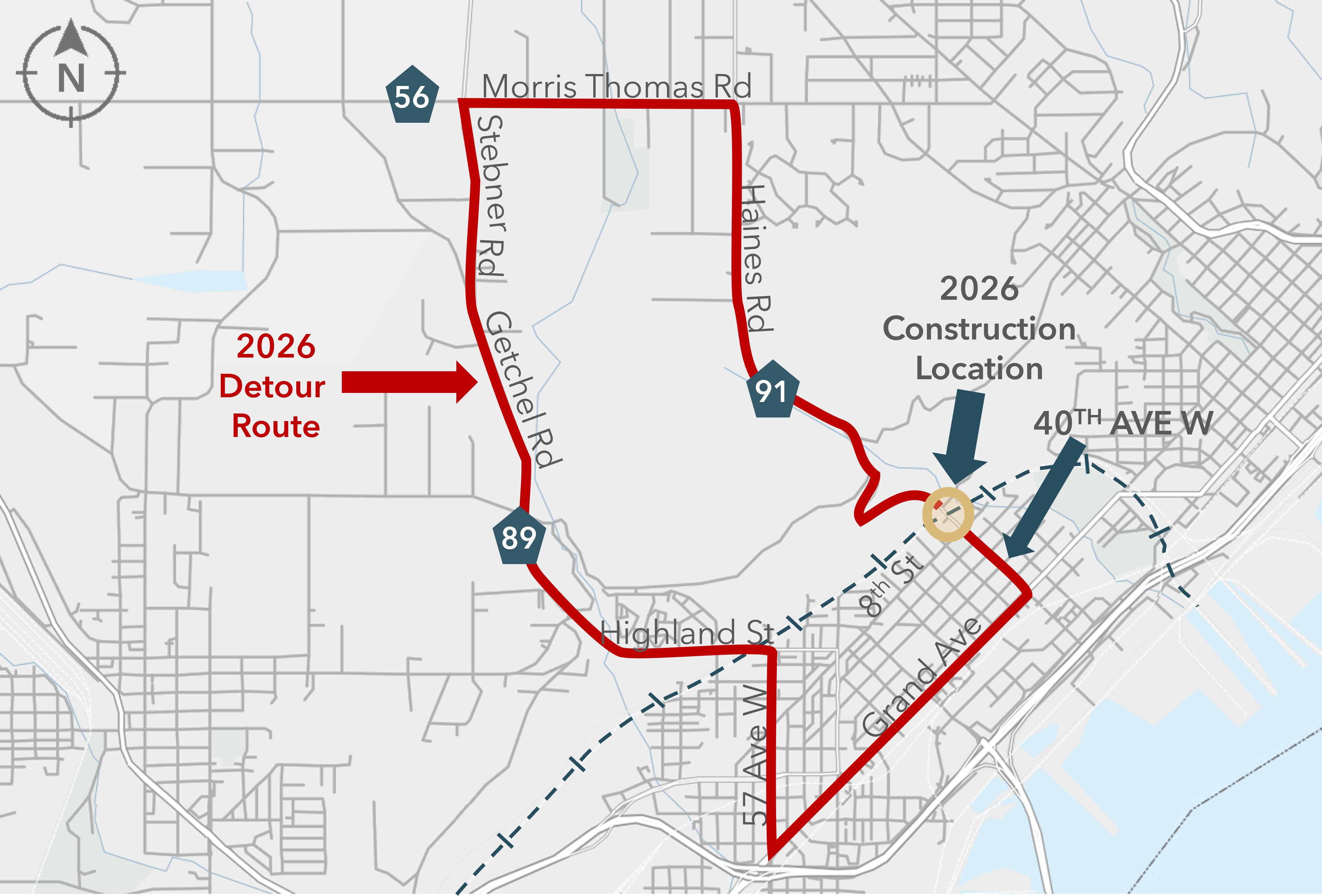

2026 Posted Detour
During the 2026 construction season, through traffic will be directed along the following signed detour route:
Morris Thomas Road → Stebner Road → Getchel Road → Highland Street → 57th Avenue West → Grand Avenue
Motorists are encouraged to follow the posted detour signs and allow additional travel time while construction is underway.
Traffic Impacts
Residents and motorists should expect:
Complete Road closures where work is occurring, but local traffic will be maintained.
Access to businesses maintained at all times with signage directing traffic.
40th Ave West Corridor Study Results
See below for the corridor study preliminary layouts or download a pdf version in the documents section of this webpage.
I-35 to Grand Ave Section:
Grand Ave to Railroad Crossing Section:
Grand Ave and 40th Ave West Intersection:
Overview
St. Louis County is leading a project in 2026-2027 to reconstruct 40th Ave West (CSAH 91) beginning at Grand Ave and ending near the railroad crossing (USDOT #251887W) for a total distance of approximately 0.42 mile. The project design is based on the preliminary layout that was developed from the 40th Ave West Corridor Study which started in September 2023 and completed in June 2024. This reconstruction project is necessary because the pavement section and curb and gutter on 40th Ave West are at the end of their service life. Likewise, the traffic signal system at the intersection of Grand Ave and 40th Ave West is nearing the end of its service life. The City of Duluth will replace city utilities along 40th Ave West in conjunction with the roadway reconstruction.
Key project components include:
Remove the traffic signal and construct a mini-roundabout at the intersection of Grand Ave and 40th Ave West.
Construct a raised center median along 40th Ave West beginning at Grand Ave and ending at 8th St. Openings in the median will be provided at intersections and alleys.
Construct a 10-ft path along the east side and a 6-ft sidewalk along the west side of 40th Ave West. Lighting will be provided for the 10-ft path and intersections.
Install an enhanced pedestrian crossing that utilizes a RRFB (pedestrian activated flasher) on 40th Ave West at 6th St.
The roadway reconstruction project in 2026 will stop approximately 100 ft short of the railroad crossing. A separate roadway reconstruction project for this gap is planned for 2027 in conjunction with a project to replace the signals and gates at the railroad crossing and extend the crossing surface. This separate roadway construction project will complete the connection of the 10-ft path on the east side of 40th Ave West to the existing sidewalk on the east side of Haines Rd.
Construction Schedule
2026 Construction
Construction is expected to begin on August 10, 2026.
Work in 2026 will be limited to between 8th Street and the railroad tracks as well as some work outside the roadway at the Members Cooperative Credit Union.
This phase of work is expected to be substantially complete by October 31, 2026.
Temporary pavement and utility connections will be installed as needed to safely maintain the roadway over the winter.
2027 Construction
Major reconstruction will resume in spring 2027.
Construction will include the remaining roadway reconstruction and construction of the new mini roundabout at Grand Avenue.
The intersection of Grand Avenue and 40th Avenue West is anticipated to reopen to traffic by late August, 2027
2026 Posted Detour
During the 2026 construction season, through traffic will be directed along the following signed detour route:
Morris Thomas Road → Stebner Road → Getchel Road → Highland Street → 57th Avenue West → Grand Avenue
Motorists are encouraged to follow the posted detour signs and allow additional travel time while construction is underway.
Traffic Impacts
Residents and motorists should expect:
Complete Road closures where work is occurring, but local traffic will be maintained.
Access to businesses maintained at all times with signage directing traffic.
40th Ave West Corridor Study Results
See below for the corridor study preliminary layouts or download a pdf version in the documents section of this webpage.
Share Design Information Meeting on FacebookShare Design Information Meeting on X (formerly Twitter)Share Design Information Meeting on LinkedinEmail Design Information Meeting link
Come hear information on the final design of the project.
Date/Time: Thursday, October 30, 2025 at 6 PM
Meeting Location: Denfeld High School in the West Commons area - 401 N 44th Ave W, Duluth, MN
Share Public Meeting #2 on FacebookShare Public Meeting #2 on X (formerly Twitter)Share Public Meeting #2 on LinkedinEmail Public Meeting #2 link
Date/Time: Monday, January 29th, 2024 at 6 PM
Meeting Location: Denfeld High School in the West Commons area
This second meeting for the project included an in-depth discussion on what was heard during the first wave of engagement. The next public meeting will take place in the spring of 2024. To view a recording of this meeting, click on the link below.
Meeting Location: Denfeld High School in the West Commons area
This second meeting for the project included an in-depth discussion on what was heard during the first wave of engagement. The next public meeting will take place in the spring of 2024. To view a recording of this meeting, click on the link below.
Share Public Meeting #1 on FacebookShare Public Meeting #1 on X (formerly Twitter)Share Public Meeting #1 on LinkedinEmail Public Meeting #1 link
Date/Time: Monday, September 18th, 2023 at 6 PM
Meeting Location: Denfeld High School in the West Commons area.
This kick-off meeting for the project was held to obtain input about concerns, issues, and future vision. The next public meeting will take place in January of 2024.
Date/Time: Monday, September 18th, 2023 at 6 PM
Meeting Location: Denfeld High School in the West Commons area.
This kick-off meeting for the project was held to obtain input about concerns, issues, and future vision. The next public meeting will take place in January of 2024.
Page last updated: 15 Jul 2026, 08:37 AM
Follow Project
Stay informed
Subscribe for project updates
Anticipated Timeline
Public Meeting #1
40th Ave W (CSAH 91) - Reconstruction has finished this stage
Sept. 18, 2023 | 6:00 PM Denfeld High School
Kick-off meeting to obtain input about concerns, issues, and future vision.
Public Survey and Comment Map
40th Ave W (CSAH 91) - Reconstruction has finished this stage
Sept. - Oct. 2023 Online
Survey and comment map are open for input from the general public.
Public Meeting #2
40th Ave W (CSAH 91) - Reconstruction has finished this stage
Jan. 29, 2024 | 6:00 PM Denfeld High School
Provide input on alternatives.
Public Meeting #3
40th Ave W (CSAH 91) - Reconstruction has finished this stage
Provide information on the final design of the project.
2026 Construction - August 10 through October 31
40th Ave W (CSAH 91) - Reconstruction is currently at this stage
August 10, 2026
Work in 2026 will be limited to between 8th Street and the railroad tracks as well as some work outside the roadway at the Members Cooperative Credit Union.
2027 Construction - Spring through August
this is an upcoming stage for 40th Ave W (CSAH 91) - Reconstruction
Major reconstruction will resume in spring 2027.
Construction will include the remaining roadway reconstruction and construction of the new mini roundabout at Grand Avenue.
The intersection of Grand Avenue and 40th Avenue West is anticipated to reopen to traffic by late August, 2027.
The contractor will work to minimize impacts to residents by:
Residents with no access to off street parking on their property from side street or alleys will have a clear and concise ways for vehicular and/or pedestrian access.
Maintaining vehicle and pedestrian access to homes whenever possible.
Maintaining pedestrian crossings of 40th Avenue West during construction.
Coordinating access for residents who have limited driveway or parking access.
How will my mail and garbage service be impacted?
Temporary mailboxes will be provided whenever mail delivery is affected.
The contractor will coordinate with the U.S. Postal Service before any changes to mail delivery.
Garbage and recycling service will continue through coordination with local waste haulers.
What are the typical construction hours and will there be work done on weekends?
Construction activities are generally limited to:
Monday through Friday: 7:00 a.m. – 7:00 p.m.
Saturday: 8:00 a.m. – 5:00 p.m.
No construction work is anticipated on Sundays or during the following holiday weekends:
Labor Day 2026
Memorial Day 2027
Independence Day 2027
Labor Day 2027
As a resident, what can I expect?
Throughout construction, residents may experience:
Temporary traffic delays and detours.
Construction noise and heavy equipment.
Temporary changes to parking and driveway access.
Utility work occurring before roadway reconstruction.
Ongoing schedule updates as construction progresses.
